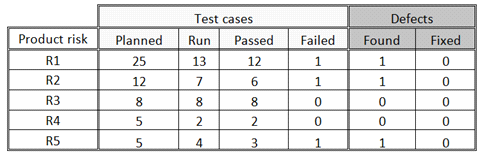

You are not confident with the assessment of the risk level and you suspect that it will be possible to find high-priority bugs in low-risk areas.
Furthermore the period for test execution is very short. Your goal is to test all the product risks in a risk-based way, while assuring that each product risk gets at least some amount of testing.

Which of the following answers describes the best test execution schedule in this scenario?
Number of correct responses: 1
Answer : B

Which of the following statements represents the most effective contribution of the stakeholders to the completion of the failure mode analysis table?

Number of correct responses: 1
Answer : B

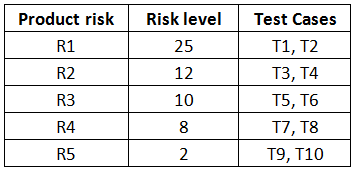

You are following a risk-based testing strategy. The test execution time is very limited. Assume that all the product risk items require more or less the same level of test effort.

Which of the following answers describes the best execution schedule in this scenario?
Number of correct responses: 1
Answer : D

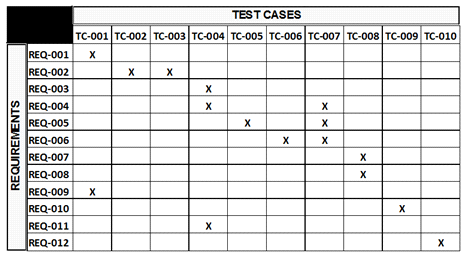

Assume that the following test cases have been executed at the end of the first week of test execution: TC-001, TC-002 and TC-007. All these tests are 'passes'.
What is the MINIMUM number of the remaining test cases that must be successfully executed to fulfill the EX1 exit criteria?

Number of correct responses: 1
Answer : A
You are estimating the effort for the integration testing activities of a new project. Consider the following factors, which can affect that estimation:
Availability of re-usable test systems and documentation from previous, similar projects
Unexpected timing of components arrival

Stability of the integration test team (no turnover)
Many and geographically distributed sub-teams
Which of the following statements is true?
Number of correct responses: 1
Answer : C
The following are the exit criteria described in the test plan of a software product:
EX1. The test suite for the product must ensure that at least each quality risk item is covered by at least one test case (a quality risk item can be covered by more test cases).
EX2. All test cases in the test suite must be run during the execution phase.
EX3. Defects are classified into two categories: ''C'' (critical defect) and ''NC'' (non-critical defect). No known C defects shall exist in the product at the end of the test execution phase.
Which of the following information is useless when the specified exit criteria is evaluated?
Number of correct responses: 1
Answer : C
Which of the following statements, about the test reporting activities for a project adopting an iterative lifecycle model with very short iterations (e.g. two weeks iterations), is correct?
Number of correct responses: 1
Answer : D
