Project scenario - Get fit with football!
(Note: The companies and people within the scenario are fictional)
Introduction
A Local Government Authority (LGA) has decided to organize a six-a-side football tournament. The tournament will contribute towards achieving the targets set by a national initiative to improve the fitness of children under the age of 16. As part of the LGA's policy of self-funding, this has to be achieved at zero cost to the LGA (and therefore the local tax payer). The cost of the event will be covered through fees paid by teams registered to take part in the tournament, sponsorship and monies raised during the day. Any surplus would be used for the maintenance of local sports centres.
Teams can register under one of several age groups for both boys and girls. In addition, family members are asked to attend to provide support.
This sports event is designed to be a family day out. The football tournament will have an event village including a kidz'-zone, catering, car parking, mobile changing rooms and toilets. The tournament will take place on the LGA-owned football pitches near the centre of the town, although space is somewhat limited.
Scope
The initial scope of the project includes:
The project has been set up with four work streams to deliver this work:
1. Marketing
2. Website
3. Event Village
4. Staff Training
Project Background
The LGA have extensive experience in using PRINCE2 and will run the event as a single project. The project manager is fully conversant with PRINCE2 Agile. One office in the LGA building in the centre of town has been given to the project for the entire duration. The office is across the corridor from the Marketing Department and the project manager has already put a sign on the door that says 'Mission Control'.
Timeline

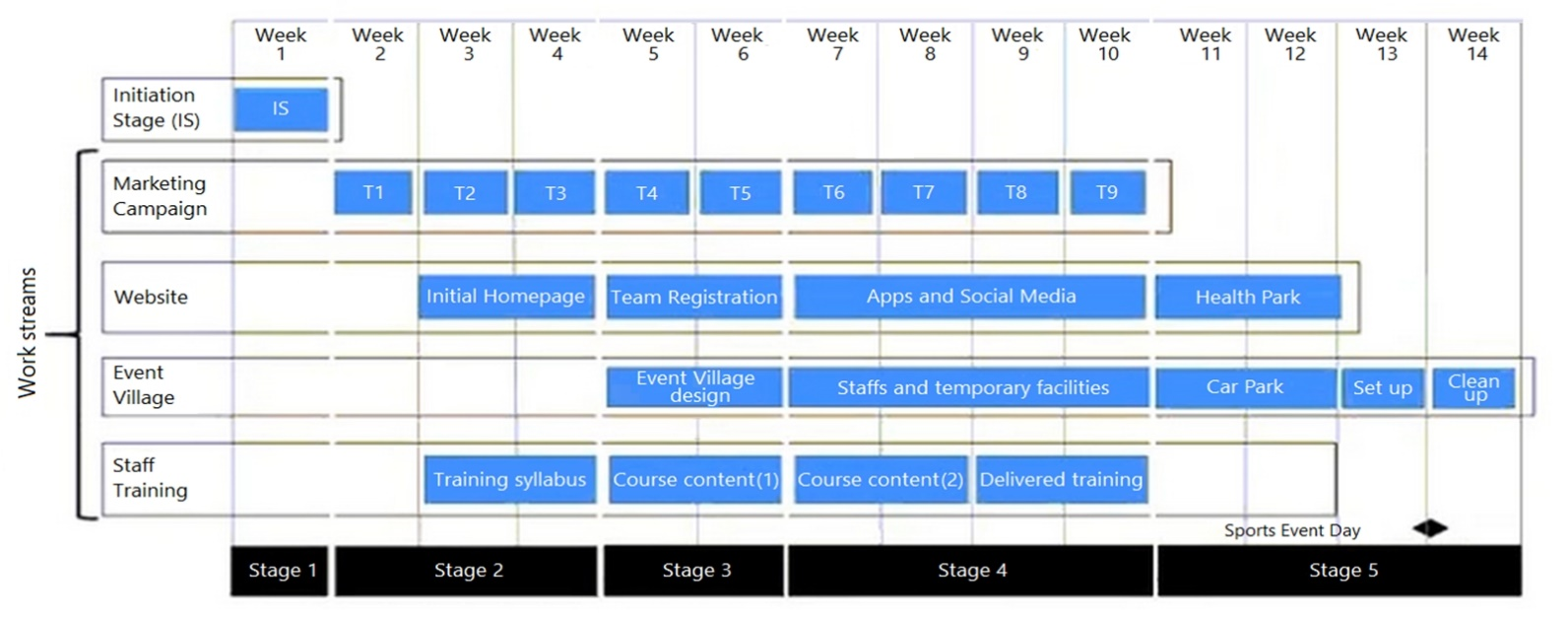

An initial timeline has been suggested and is shown in the following diagram. The timeline may evolve due to the agile ways of working. The timeline shows how work streams are broken down into work packages and/or timeboxes.

Staff Training - Additional information
The event will be supervised primarily by LGA staff volunteers. They will need to be trained in various skills so that:
A . the event is carried out safely and professionally;
B . staff members are able to give advice on health and fitness.
This is covered by four work packages:
1. Training syllabus:
* High-level design of the manual.
* Content of each module.
2. Course content for safety and professionalism:
* Detailed design of two modules:
* Health and Safety including basic first aid.
* Customer relations to look after people attending the event.
* Piloting the modules with a group of volunteers.
3. Course content tor giving advice on health and fitness:
* Detailed design of two modules:
* Exercise fundamentals including how to warm up and cool down.
* Healthy eating including what types of food are good for you.
* Piloting the modules with a group of volunteers.
4. Training delivery:
* Production of the training manual;
* Delivery of the training to the rest of the volunteers.
The Staff Training Team is staffed by in-house training staff members that have been involved in several waterfall projects but have not had any exposure to agile.
Using the Project Scenario and Staff Training Additional information, answer the following question:
The Staff Training team manager made a request for an additional full-time customer subject matter expert (CSME) to be allocated to the Staff Training Team for the next timebox, which is in Stage 3. This person is responsible for health and safety training within the LGA.
What BEST explains why this approach complies with the 'keep teams stable' target?
Answer : B
By requesting an additional full-time customer subject matter expert (CSME) for the next timebox, the team manager ensures that the necessary expertise is available to the Staff Training Team. This stability in skills and resources helps the team maintain continuity in their work and increases the likelihood of successful delivery, aligning with the principle of keeping teams stable.
Project scenario - Get fit with football!
(Note: The companies and people within the scenario are fictional)
Introduction
A Local Government Authority (LGA) has decided to organize a six-a-side football tournament. The tournament will contribute towards achieving the targets set by a national initiative to improve the fitness of children under the age of 16. As part of the LGA's policy of self-funding, this has to be achieved at zero cost to the LGA (and therefore the local tax payer). The cost of the event will be covered through fees paid by teams registered to take part in the tournament, sponsorship and monies raised during the day. Any surplus would be used for the maintenance of local sports centres.
Teams can register under one of several age groups for both boys and girls. In addition, family members are asked to attend to provide support.
This sports event is designed to be a family day out. The football tournament will have an event village including a kidz'-zone, catering, car parking, mobile changing rooms and toilets. The tournament will take place on the LGA-owned football pitches near the centre of the town, although space is somewhat limited.
Scope
The initial scope of the project includes:
The project has been set up with four work streams to deliver this work:
1. Marketing
2. Website
3. Event Village
4. Staff Training
Project Background
The LGA have extensive experience in using PRINCE2 and will run the event as a single project. The project manager is fully conversant with PRINCE2 Agile. One office in the LGA building in the centre of town has been given to the project for the entire duration. The office is across the corridor from the Marketing Department and the project manager has already put a sign on the door that says 'Mission Control'.
Timeline
An initial timeline has been suggested and is shown in the following diagram. The timeline may evolve due to the agile ways of working. The timeline shows how work streams are broken down into work packages and/or timeboxes.

Website - Additional information
A new website will be built for the event. There are five work packages within this product:
1. Initial homepage:
2. Team Registration functionality:
3. Social media promoting the event and its aims.
4. Applications (apps) to promote healthy lifestyles including fitness and healthy eating apps.
5. Health Park:
The Website Team have a lot of experience in IT and have been using agile for several years. They are delivering the website through five two-week timeboxes. The team uses a Scrum Master to facilitate and the Scrum process and coach people accordingly.
The Website Team are very good at Scrum. They have created a set of tasks to assess more difficult work and they refer to this as sprint zero.
Using the Project Scenario and Website Additional information, answer the following question:
The Scrum Master has been advised by the supplier subject matter expert that the five day task of building the social media website is now almost complete - there is just one more day's work to do.
How should this be shown on the burn-down chart?
Answer : B
The burn-down chart should reflect the current status of work remaining accurately. Since there is less than one day's worth of work left, marking the task as almost complete provides a clearer picture of progress and helps the team understand how much effort is needed to finish the task. This approach promotes transparency and effective tracking of progress.
Project scenario - Get fit with football!
(Note: The companies and people within the scenario are fictional)
Introduction
A Local Government Authority (LGA) has decided to organize a six-a-side football tournament. The tournament will contribute towards achieving the targets set by a national initiative to improve the fitness of children under the age of 16. As part of the LGA's policy of self-funding, this has to be achieved at zero cost to the LGA (and therefore the local tax payer). The cost of the event will be covered through fees paid by teams registered to take part in the tournament, sponsorship and monies raised during the day. Any surplus would be used for the maintenance of local sports centres.
Teams can register under one of several age groups for both boys and girls. In addition, family members are asked to attend to provide support.
This sports event is designed to be a family day out. The football tournament will have an event village including a kidz'-zone, catering, car parking, mobile changing rooms and toilets. The tournament will take place on the LGA-owned football pitches near the centre of the town, although space is somewhat limited.
Scope
The initial scope of the project includes:
The project has been set up with four work streams to deliver this work:
1. Marketing
2. Website
3. Event Village
4. Staff Training
Project Background
The LGA have extensive experience in using PRINCE2 and will run the event as a single project. The project manager is fully conversant with PRINCE2 Agile. One office in the LGA building in the centre of town has been given to the project for the entire duration. The office is across the corridor from the Marketing Department and the project manager has already put a sign on the door that says 'Mission Control'.
Timeline
An initial timeline has been suggested and is shown in the following diagram. The timeline may evolve due to the agile ways of working. The timeline shows how work streams are broken down into work packages and/or timeboxes.

Event Village - Additional information
The aim of the event village is to provide a range of services and activities for anyone attending the football tournament.
The event village will comprise a number of work packages:
1. Event village design
2. A 'kids-zone' which includes trampolines and swings, as well as the opportunity to try out other sporting activities
3. Stalls which will be sold to local businesses to raise funds for the event:
4. A car park for 200 cars.
5. Temporary facilities including changing rooms, toilets and shower facilities.
6. Dismantling of the event village and clean up.
The Event Village Team is assembled using staff from various LGA departments who have no experience of working with agile.
Using the Project Scenario and Event Village Additional information, answer the following question:
The project manager used the Agilometer to assess the prevailing agile environment and, consequently, took action to improve the low score achieved on the 'flexibility on what is delivered' slider.
When should the project manager undertake a further assessment in order to determine if further action is required to increase the slider score?
Answer : B
The sprint retrospective is an opportunity for the team to reflect on the sprint, discuss what went well, what could be improved, and how to enhance processes moving forward. Assessing the Agilometer score at this point allows the project manager and the team to evaluate the effectiveness of actions taken and make adjustments as needed to improve flexibility in future sprints.
Project scenario - Get fit with football!
(Note: The companies and people within the scenario are fictional)
Introduction
A Local Government Authority (LGA) has decided to organize a six-a-side football tournament. The tournament will contribute towards achieving the targets set by a national initiative to improve the fitness of children under the age of 16. As part of the LGA's policy of self-funding, this has to be achieved at zero cost to the LGA (and therefore the local tax payer). The cost of the event will be covered through fees paid by teams registered to take part in the tournament, sponsorship and monies raised during the day. Any surplus would be used for the maintenance of local sports centres.
Teams can register under one of several age groups for both boys and girls. In addition, family members are asked to attend to provide support.
This sports event is designed to be a family day out. The football tournament will have an event village including a kidz'-zone, catering, car parking, mobile changing rooms and toilets. The tournament will take place on the LGA-owned football pitches near the centre of the town, although space is somewhat limited.
Scope
The initial scope of the project includes:
The project has been set up with four work streams to deliver this work:
1. Marketing
2. Website
3. Event Village
4. Staff Training
Project Background
The LGA have extensive experience in using PRINCE2 and will run the event as a single project. The project manager is fully conversant with PRINCE2 Agile. One office in the LGA building in the centre of town has been given to the project for the entire duration. The office is across the corridor from the Marketing Department and the project manager has already put a sign on the door that says 'Mission Control'.
Timeline
An initial timeline has been suggested and is shown in the following diagram. The timeline may evolve due to the agile ways of working. The timeline shows how work streams are broken down into work packages and/or timeboxes.

Website - Additional information
A new website will be built for the event. There are five work packages within this product:
1. Initial homepage:
2. Team Registration functionality:
3. Social media promoting the event and its aims.
4. Applications (apps) to promote healthy lifestyles including fitness and healthy eating apps.
5. Health Park:
The Website Team have a lot of experience in IT and have been using agile for several years. They are delivering the website through five two-week timeboxes. The team uses a Scrum Master to facilitate and the Scrum process and coach people accordingly.
The Website Team are very good at Scrum. They have created a set of tasks to assess more difficult work and they refer to this as sprint zero.
Using the Project Scenario and Website Additional information, answer the following question:
The project manager has asked the Scrum Master who will be leading the website work stream to act as team manager. The team manager will act as a single point of contact for the project manager, taking on the responsibilities of a team manager. The team manager will continue to coach and lead the Website Team.
Which BEST describes how this tailors the organization theme?
Answer : A
By having the Scrum Master act as the team manager, it emphasizes the role of the Scrum Master in supporting and serving the team while also managing the communication and responsibilities required by the project manager. This approach maintains agile principles while ensuring clarity in roles and responsibilities within the team.
Project scenario - Get fit with football!
(Note: The companies and people within the scenario are fictional)
Introduction
A Local Government Authority (LGA) has decided to organize a six-a-side football tournament. The tournament will contribute towards achieving the targets set by a national initiative to improve the fitness of children under the age of 16. As part of the LGA's policy of self-funding, this has to be achieved at zero cost to the LGA (and therefore the local tax payer). The cost of the event will be covered through fees paid by teams registered to take part in the tournament, sponsorship and monies raised during the day. Any surplus would be used for the maintenance of local sports centres.
Teams can register under one of several age groups for both boys and girls. In addition, family members are asked to attend to provide support.
This sports event is designed to be a family day out. The football tournament will have an event village including a kidz'-zone, catering, car parking, mobile changing rooms and toilets. The tournament will take place on the LGA-owned football pitches near the centre of the town, although space is somewhat limited.
Scope
The initial scope of the project includes:
The project has been set up with four work streams to deliver this work:
1. Marketing
2. Website
3. Event Village
4. Staff Training
Project Background
The LGA have extensive experience in using PRINCE2 and will run the event as a single project. The project manager is fully conversant with PRINCE2 Agile. One office in the LGA building in the centre of town has been given to the project for the entire duration. The office is across the corridor from the Marketing Department and the project manager has already put a sign on the door that says 'Mission Control'.
Timeline
An initial timeline has been suggested and is shown in the following diagram. The timeline may evolve due to the agile ways of working. The timeline shows how work streams are broken down into work packages and/or timeboxes.

Event Village - Additional information
The aim of the event village is to provide a range of services and activities for anyone attending the football tournament.
The event village will comprise a number of work packages:
1. Event village design
2. A 'kids-zone' which includes trampolines and swings, as well as the opportunity to try out other sporting activities
3. Stalls which will be sold to local businesses to raise funds for the event:
4. A car park for 200 cars.
5. Temporary facilities including changing rooms, toilets and shower facilities.
6. Dismantling of the event village and clean up.
The Event Village Team is assembled using staff from various LGA departments who have no experience of working with agile.
Using the Project Scenario and Event Village Additional information, answer the following question:
Just before the event the team finds out that a major football match is taking place during the tournament and that many people will want to see it. One solution is to hire a large TV screen to display the game in the Event Village. However, the biggest concern is that the cheapest supplier has many mandatory requirements for access, technical elements and work conditions in their contract.
If the agile environment for the project was reassessed, should the 'Advantageous Environmental Conditions' slider on the Agilometer be increased?
Answer : D
If the supplier has many mandatory requirements for access, technical elements, and work conditions that may hinder flexibility and responsiveness, it suggests that the conditions are not conducive to an agile environment. This lack of support for agile principles would warrant a reduction in the 'Advantageous Environmental Conditions' slider on the Agilometer.
Project scenario - Get fit with football!
(Note: The companies and people within the scenario are fictional)
Introduction
A Local Government Authority (LGA) has decided to organize a six-a-side football tournament. The tournament will contribute towards achieving the targets set by a national initiative to improve the fitness of children under the age of 16. As part of the LGA's policy of self-funding, this has to be achieved at zero cost to the LGA (and therefore the local tax payer). The cost of the event will be covered through fees paid by teams registered to take part in the tournament, sponsorship and monies raised during the day. Any surplus would be used for the maintenance of local sports centres.
Teams can register under one of several age groups for both boys and girls. In addition, family members are asked to attend to provide support.
This sports event is designed to be a family day out. The football tournament will have an event village including a kidz'-zone, catering, car parking, mobile changing rooms and toilets. The tournament will take place on the LGA-owned football pitches near the centre of the town, although space is somewhat limited.
Scope
The initial scope of the project includes:
The project has been set up with four work streams to deliver this work:
1. Marketing
2. Website
3. Event Village
4. Staff Training
Project Background
The LGA have extensive experience in using PRINCE2 and will run the event as a single project. The project manager is fully conversant with PRINCE2 Agile. One office in the LGA building in the centre of town has been given to the project for the entire duration. The office is across the corridor from the Marketing Department and the project manager has already put a sign on the door that says 'Mission Control'.
Timeline
An initial timeline has been suggested and is shown in the following diagram. The timeline may evolve due to the agile ways of working. The timeline shows how work streams are broken down into work packages and/or timeboxes.

Event Village - Additional information
The aim of the event village is to provide a range of services and activities for anyone attending the football tournament.
The event village will comprise a number of work packages:
1. Event village design
2. A 'kids-zone' which includes trampolines and swings, as well as the opportunity to try out other sporting activities
3. Stalls which will be sold to local businesses to raise funds for the event:
4. A car park for 200 cars.
5. Temporary facilities including changing rooms, toilets and shower facilities.
6. Dismantling of the event village and clean up.
The Event Village Team is assembled using staff from various LGA departments who have no experience of working with agile.
Using the Project Scenario and Event Village Additional information, answer the following question:
The typical approach to planning taken by the Event Village team is for the plans to be developed by the project manager and the Event Village team manager, and then presented to the team.
Which setting on the Agilometer is the MOST appropriate to reflect this approach?
Answer : C
Since the planning is primarily developed by the project manager and the Event Village team manager and then presented to the team, it indicates a lack of full team involvement in the planning process. This approach suggests that the acceptance and understanding of agile principles within the team could be improved, warranting a Low/Medium rating for 'acceptance of agile.'
Project scenario - Get fit with football!
(Note: The companies and people within the scenario are fictional)
Introduction
A Local Government Authority (LGA) has decided to organize a six-a-side football tournament. The tournament will contribute towards achieving the targets set by a national initiative to improve the fitness of children under the age of 16. As part of the LGA's policy of self-funding, this has to be achieved at zero cost to the LGA (and therefore the local tax payer). The cost of the event will be covered through fees paid by teams registered to take part in the tournament, sponsorship and monies raised during the day. Any surplus would be used for the maintenance of local sports centres.
Teams can register under one of several age groups for both boys and girls. In addition, family members are asked to attend to provide support.
This sports event is designed to be a family day out. The football tournament will have an event village including a kidz'-zone, catering, car parking, mobile changing rooms and toilets. The tournament will take place on the LGA-owned football pitches near the centre of the town, although space is somewhat limited.
Scope
The initial scope of the project includes:
The project has been set up with four work streams to deliver this work:
1. Marketing
2. Website
3. Event Village
4. Staff Training
Project Background
The LGA have extensive experience in using PRINCE2 and will run the event as a single project. The project manager is fully conversant with PRINCE2 Agile. One office in the LGA building in the centre of town has been given to the project for the entire duration. The office is across the corridor from the Marketing Department and the project manager has already put a sign on the door that says 'Mission Control'.
Timeline
An initial timeline has been suggested and is shown in the following diagram. The timeline may evolve due to the agile ways of working. The timeline shows how work streams are broken down into work packages and/or timeboxes.

Website - Additional information
A new website will be built for the event. There are five work packages within this product:
1. Initial homepage:
2. Team Registration functionality:
3. Social media promoting the event and its aims.
4. Applications (apps) to promote healthy lifestyles including fitness and healthy eating apps.
5. Health Park:
The Website Team have a lot of experience in IT and have been using agile for several years. They are delivering the website through five two-week timeboxes. The team uses a Scrum Master to facilitate and the Scrum process and coach people accordingly.
The Website Team are very good at Scrum. They have created a set of tasks to assess more difficult work and they refer to this as sprint zero.
Using the Project Scenario and Website Additional information, answer the following question:
The project manager facilitated a visioning workshop to develop the project product description.
Which statement, captured during the workshop, should be recorded in the project product description under the 'Composition' heading?
Answer : A
The 'Composition' section of the project product description details the specific elements and components that make up the product. This statement outlines the exact data and requirements that the team registration must capture, providing clarity on what the registration process entails.
